Manufacturing Production Scheduling Overview

The Manufacturing Production Scheduling function is a planning tool that provides a graphical based calendar to represent different views of the production process for active production orders and/or their requirements.

Considerations regarding Scheduling:

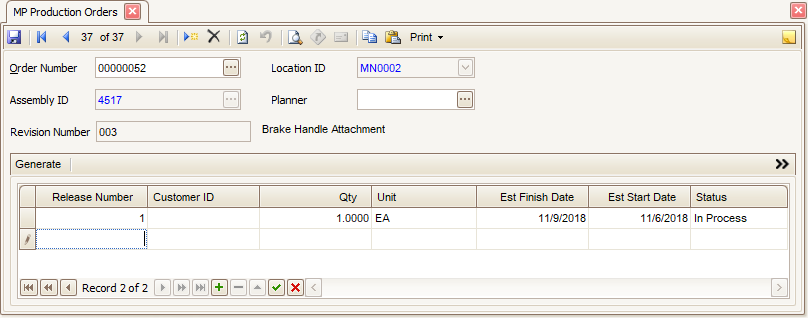

  • The finished goods entry does not include time, and is expected to be "finished" and available at the beginning of the Estimated Finish Date of the release. Depending on the schedule used for each operation, Finished Goods may appear to block more time than necessary (extend past the last process).

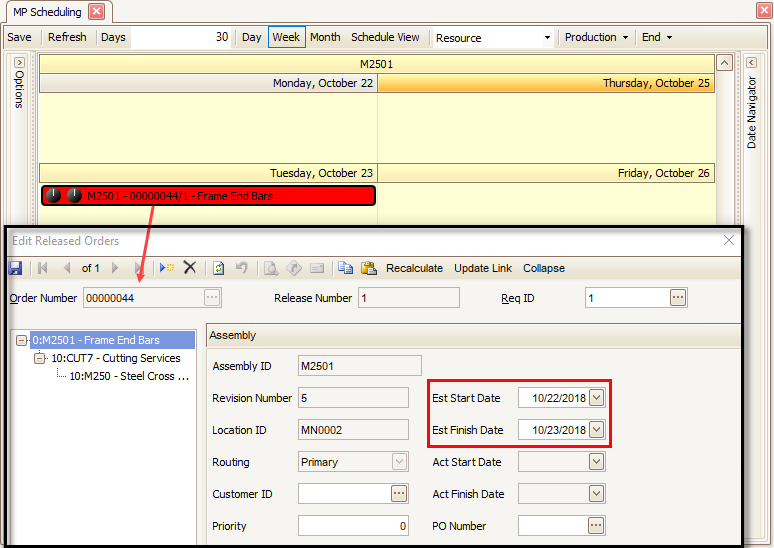

  • The release/requirement recalculation process evaluates the effective time required for each operation as part of the entire production order. It then works backward from the estimated finish date, evaluating the time available on the schedule associated with each operation to determine when it needs to start.

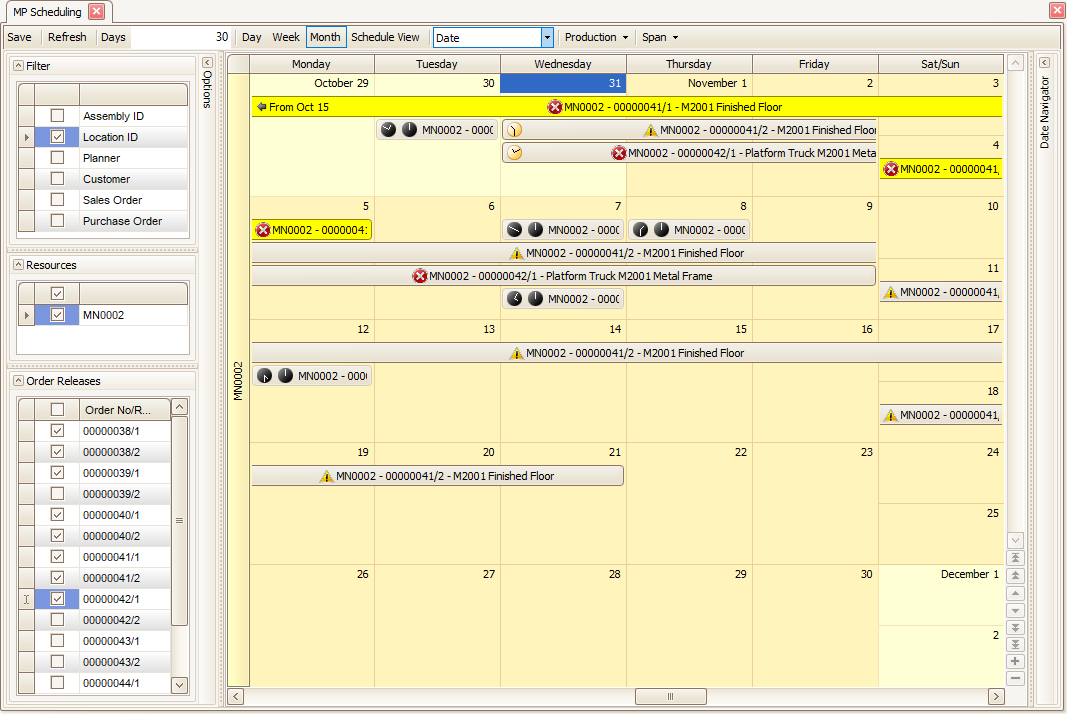

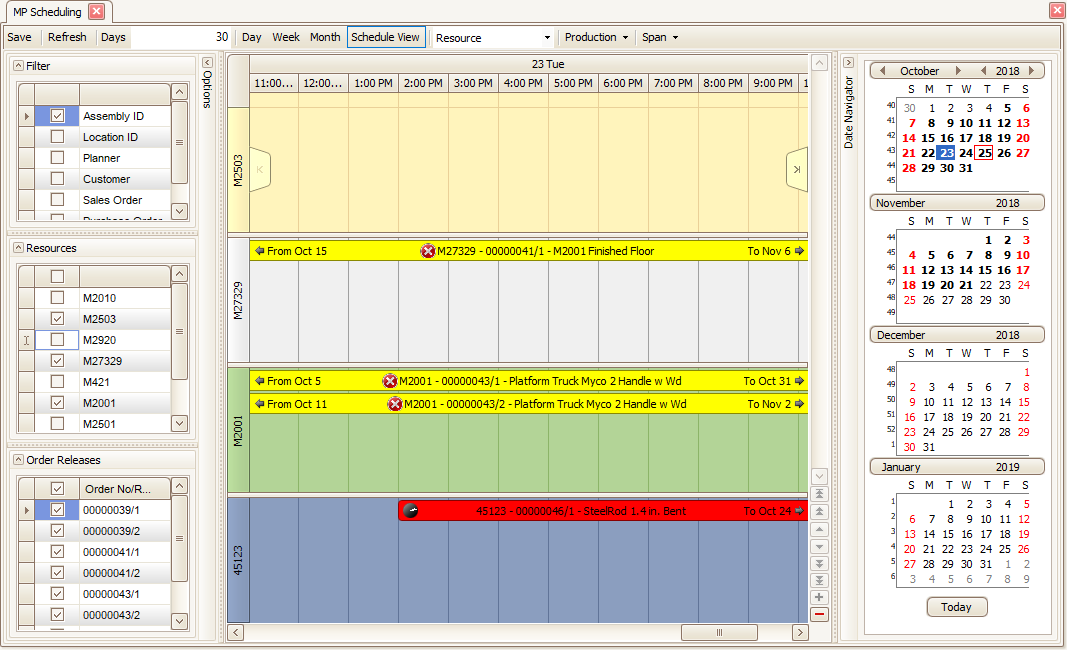

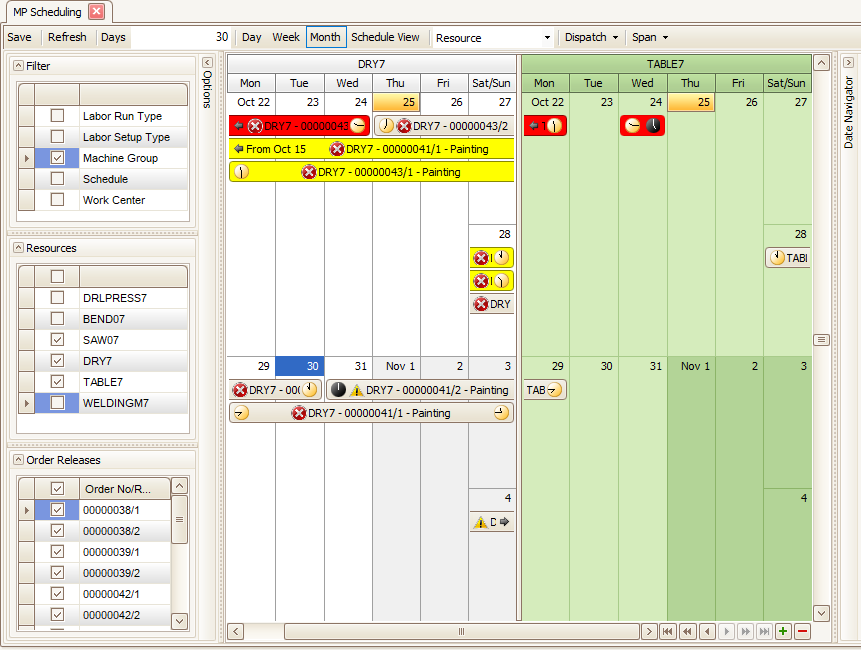

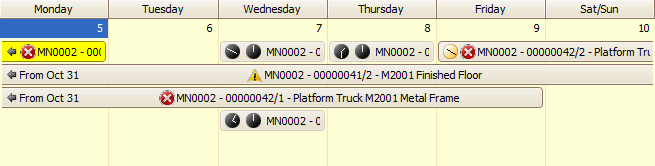

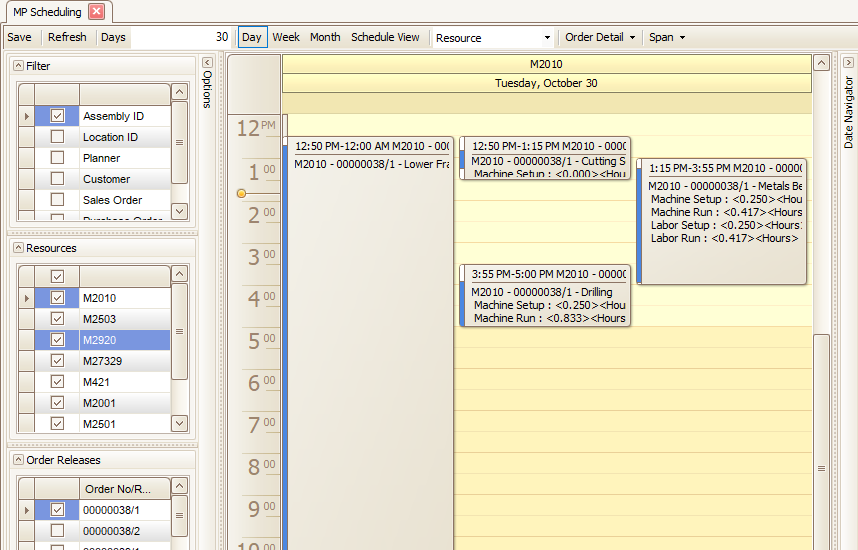

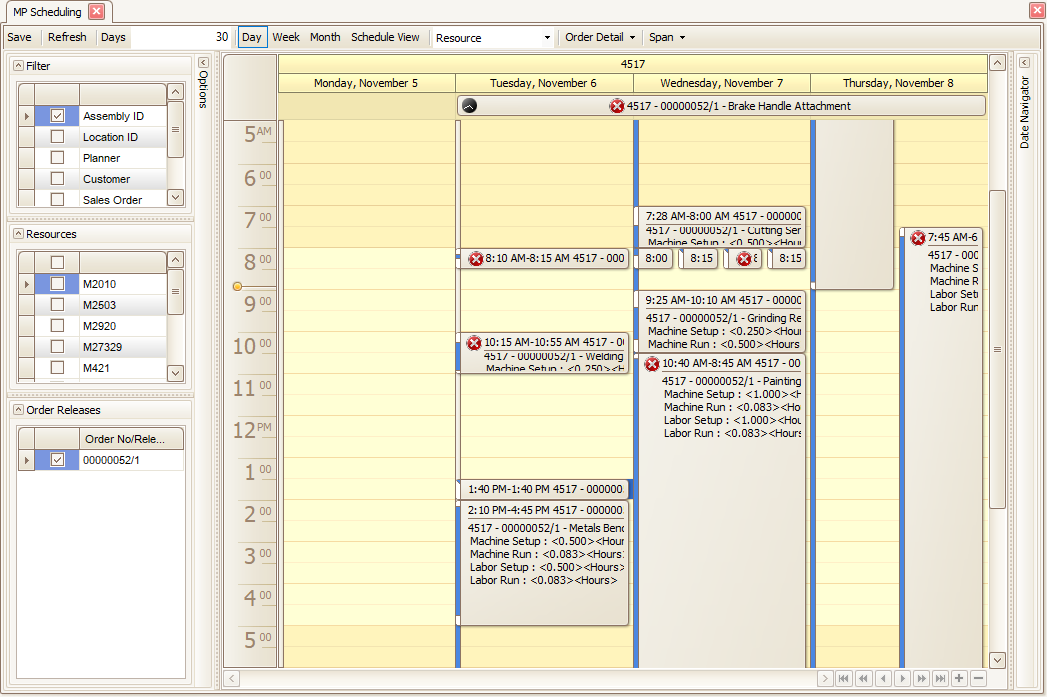

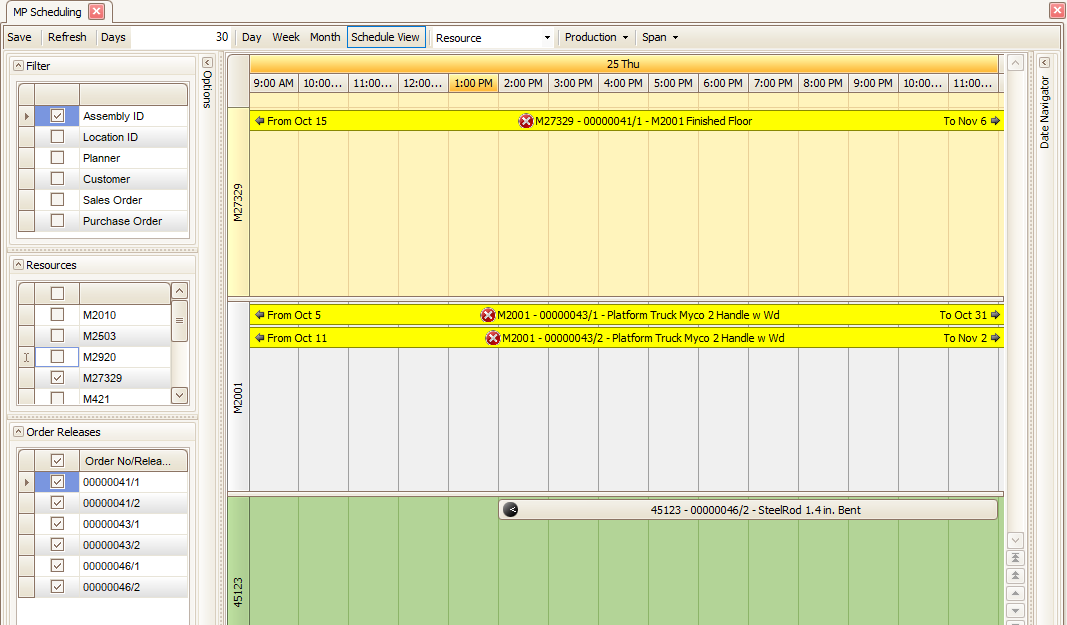

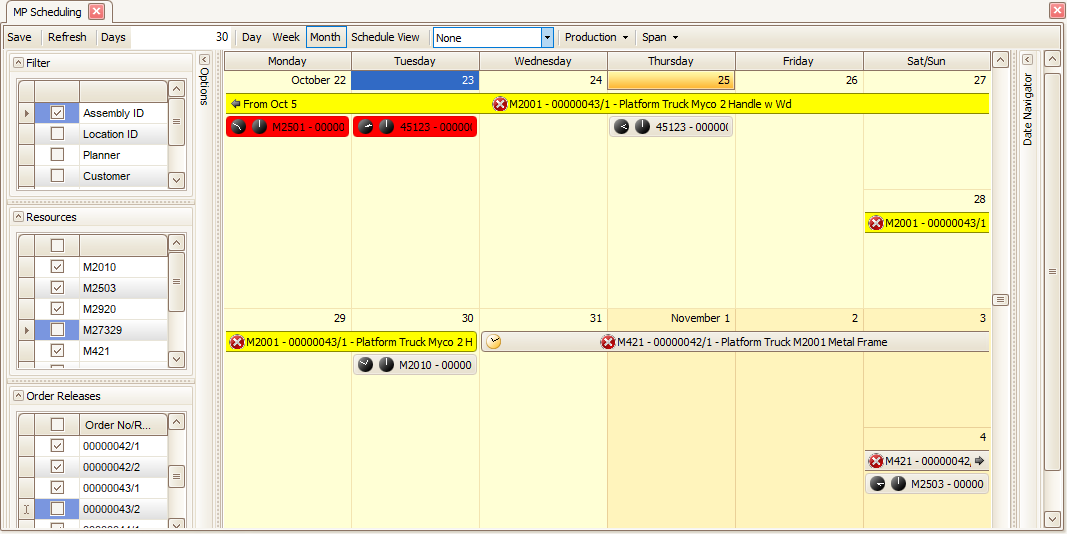

  • When you display the Span of time for an operation, the scheduling calendar will block the time from start to finish. If the operation extends past the end of the day for the given schedule, the block will continue to the beginning of the next day. Since the date/time evaluation is processed backward, the example of a 4.55 hour operation that starts at 4:15 pm would be evaluated as needing to start at 4:15 pm of the prior day in order to be available at 8:50 AM. It would need to extend into the prior day in order for the schedule to have time available to complete the process.

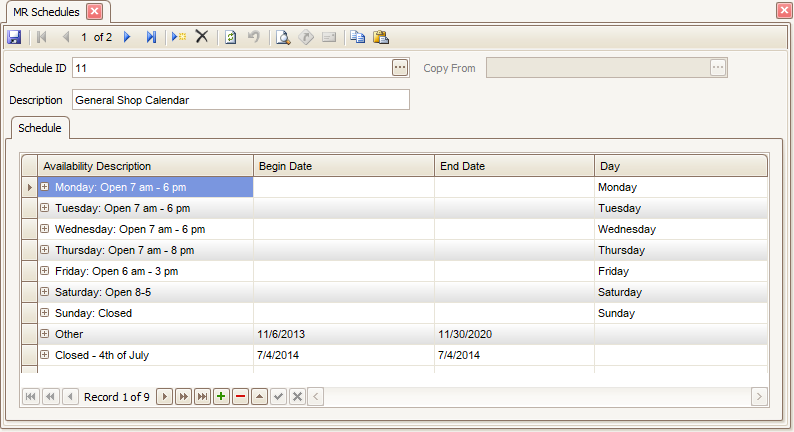

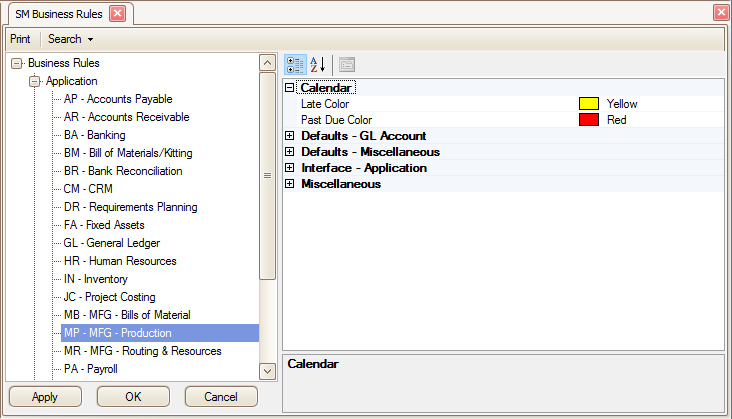

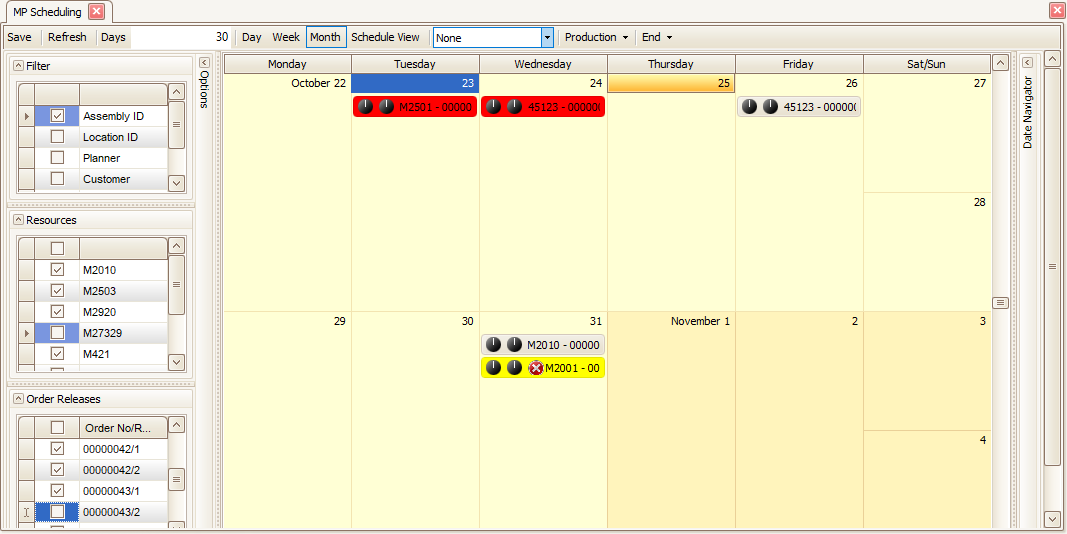

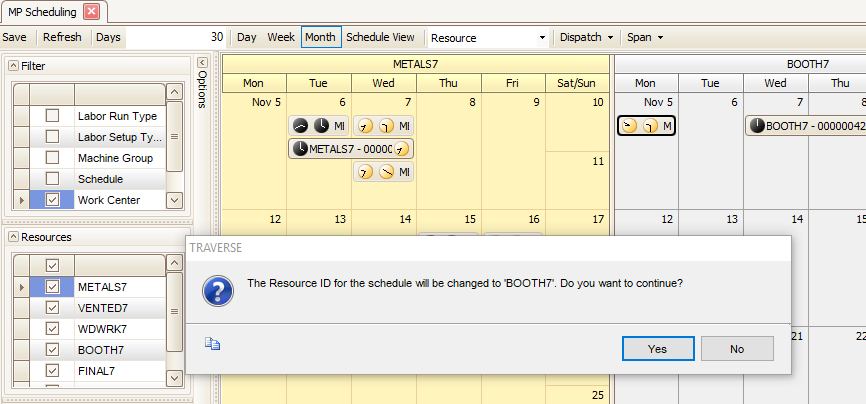

  • Holidays and other "down time" are included in the respective schedules used for each operation. The lack of time available will result in the operations being moved to bypass the dates that are unavailable. The specific dates that are unavailable in a given schedule definition are not listed on the display, since a given production order may combine multiple schedule definitions.

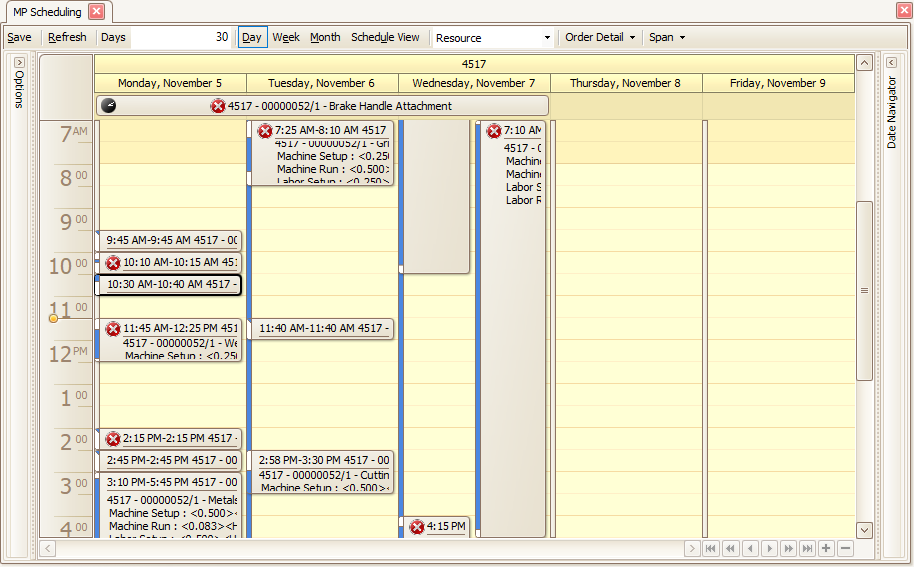

  • The clock icons represent the start or stop time for the item on the calendar depending upon the current view. It will toggle between the clock icon and text when the times do not fall on an even break of the current timescale (15 min, hourly, etc).

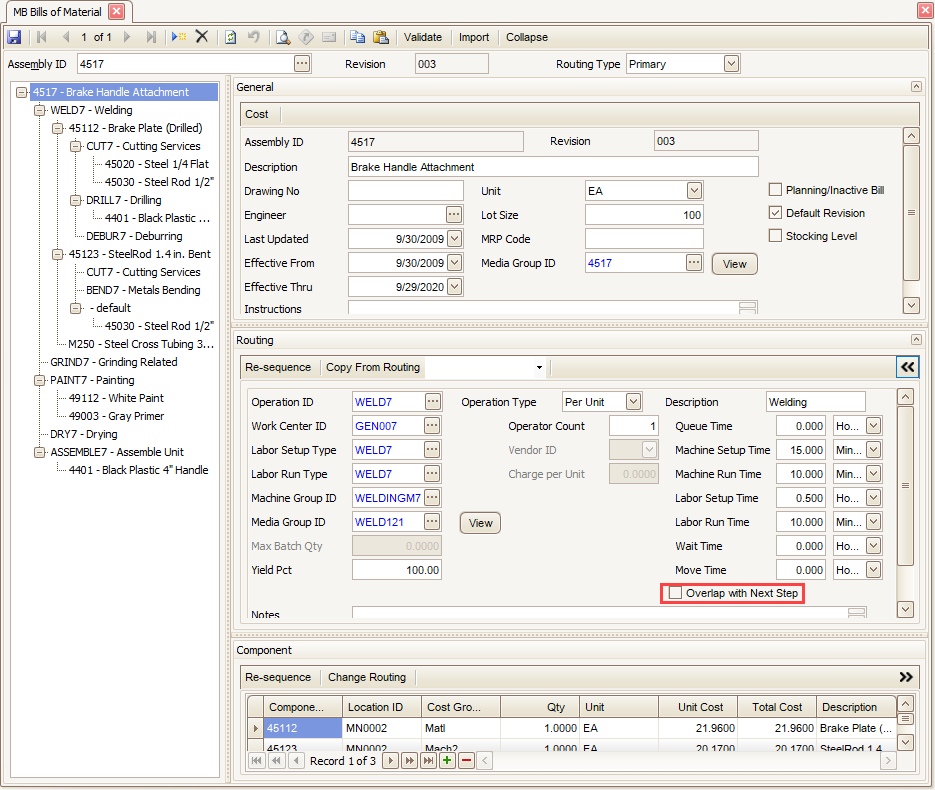

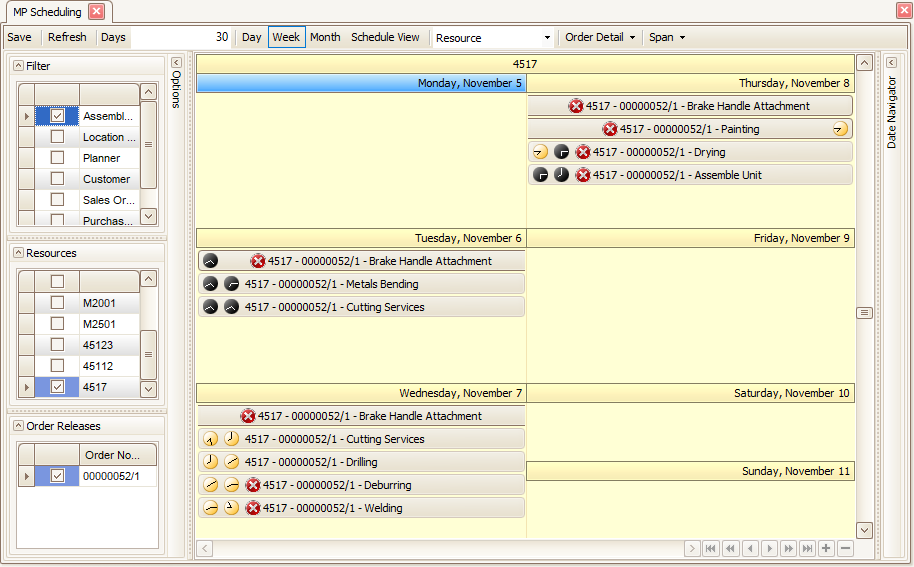

  • If you assign multiple operators to an operation, the scheduler will divide the total labor required by the number of operators. The greater of machine time or labor time (divided among multiple operators) will be used for scheduling. See the Multiple Operator Overview for more information.
